De-Risk the Supply Chain, Keep Procurement on the Critical Path

Long-lead items like transformers now take 160+ weeks. Learn 4 ways to de-risk your construction supply chain and keep procurement on the critical path.

This article originally appeared in Texas Contractor on September 28, 2026.

A substation transformer ordered today won't show up for roughly three years. That's not a typo, and it's not a worst-case estimate — industry lead times for substation transformers have stretched from around 140 weeks in 2023 to more than 160 weeks now, according to Wood Mackenzie research cited by Data Center Knowledge, with some buyers reporting waits closer to four years for certain configurations.

Structural steel is a different animal but tells the same story: fabrication and delivery are running 14 to 20 weeks in most U.S. markets in 2026 — and that's before design development and submittal review, which can add another month or more.

If you're running a project with either of those items anywhere near your critical path, the schedule you build on day one is making a bet on numbers that were already moving before you finished writing them down.

Making Invisible Lead Times Visible

Every experienced project manager already knows procurement can blow up a schedule. What's changed is how often that risk sits buried where nobody's looking.

A traditional critical path method (CPM) schedule represents a long-lead item as a single activity: order date, duration, delivery date. That's technically correct and practically useless, because it treats a transformer or a steel package as one block instead of the multi-stage process it actually is — submittal, approval, fabrication, factory testing, shipping, delivery, installation. Each of those stages has its own risk, its own owner, and its own chance of slipping. Compress all of that into one bar on a Gantt chart and you've compressed the visibility right along with it.

The result is a schedule that looks fine until the week someone realizes the submittal for a critical switchgear package never actually got approved, and the fabrication clock nobody thought to track hasn't started.

The Problem: Sequencing, Not Procurement

The instinct is to treat long-lead items as the procurement department's job to track separately from the schedule. That's exactly the disconnect that causes the damage.

A transformer delivery date only matters in relation to everything downstream of it — energization, testing, commissioning, substantial completion. If procurement is tracking delivery dates in a spreadsheet and the scheduler is tracking sequence logic in P6, the two systems agree with each other right up until the day they don't.

The fix isn't better procurement software. It's putting procurement milestones directly into the sequence logic where the whole project team, including trade partners, can see how a slipping submittal date actually cascades. A visual, whiteboard-style planning environment — where the master schedule, the lookahead, and the procurement log live on the same canvas instead of three disconnected systems — makes that cascade visible to everyone, not just the person who happens to own the spreadsheet.

4 Strategies to Uncover Slip and Recover

Break Long-Lead Items Into Sub-Activities

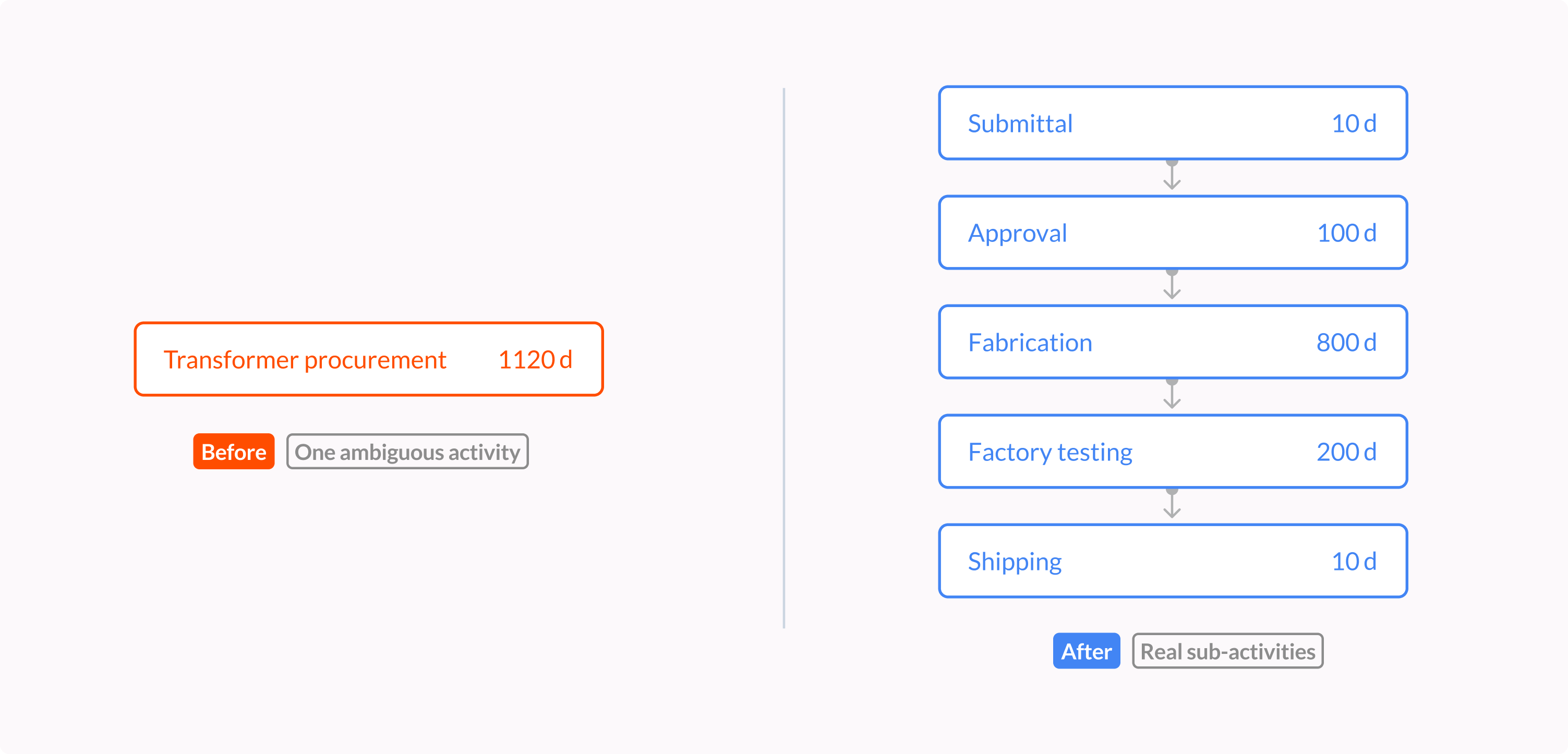

Don't schedule "transformer procurement" as one 160-week bar. Schedule submittal, approval, fabrication milestones, factory acceptance testing, and shipping as separate, sequenced activities, each with its own float. That's the only way to see which sub-stage is actually eating your buffer.

Tie Procurement Milestones to Trade Partner Logic
Look beyond the master schedule. A submittal approval delay on an electrical package doesn't just push a delivery date — it pushes every downstream trade waiting on that equipment to start their work. Make sure the schedule shows that chain explicitly, so a two-week slip in engineering review shows up as a visible impact on the electrical subcontractor's start date, not a surprise three months later.

Involve Trade Partners in Sequencing Conversations Early
Subcontractors and suppliers usually know before the general contractor when a fabrication timeline is slipping. A collaborative planning environment where they can flag that directly onto the shared schedule catches the problem when there's still float to recover it. A monthly status meeting catches it after the float is gone.

Revisit Long-Lead Assumptions
‍
Do this on a cadence that matches how fast the market is moving, not how fast your schedule updates. Steel and electrical equipment pricing and delivery windows have moved enough in the past two years that lead-time assumptions baked into a schedule at bid time can be stale by the time procurement actually places the order. Build in a checkpoint to revalidate long-lead durations against current market data before they become the excuse for a missed milestone.

What This Buys You

None of this changes the underlying reality that a substation transformer takes three years to build. It changes how much runway you have to react when a piece of that three-year chain slips. A submittal delay caught in week two — while there's still float elsewhere in the schedule — is a resequencing conversation. The same delay discovered in month 11 — after the float from every other trade has already been consumed — is a claim.

Heavy civil projects have always lived and died on long-lead procurement. That part isn't new. What's changed is the volatility. Transformer lead times don't move by a few weeks anymore; they move by tens of weeks, sometimes hundreds, year over year. A schedule that treats procurement as a single static bar can't absorb that kind of movement. A schedule that treats it as a sequence of visible, trackable, collaboratively owned milestones can.

The projects that stay on the critical path aren't the ones that got lucky on lead times. They're the ones that saw the slip coming early enough to do something about it.

Resources for modern
construction professionals

See all posts →
Planera product updates, November 2026: Constructability Agent, Planera and Procore Agent, Planera MCP

Product Updates

What's new in Planera: November 2026

Read More

Product Updates

Planera Is Bringing Construction Schedules to Claude and ChatGPT

Read More

Articles

Sticking with P6 Isn’t Risk-Averse. It’s Reckless.

Read More

What's new in Planera: November 2026
Planera Is Bringing Construction Schedules to Claude and ChatGPT
Sticking with P6 Isn’t Risk-Averse. It’s Reckless.
‍Planera and Procore Connect RFIs to the CPM Schedule with New Schedule Risk Scanner Agent
Beyond P6: The Cost of Standing Still
P6 Set the Standard. We're Raising It.
Planera Accelerates Data Center Momentum as Hyperscale AI Boom Overwhelms Legacy Construction Scheduling Tools
What Is Percent Plan Complete in Construction and How Does It Work?
How to Build a Reliable Weekly Work Plan for a Construction Project
What's new in Planera: October 2026
Why Data Center Construction Projects Fall Behind Schedule and Delays Happen
A Step-by-Step Guide on How to Update a Construction CPM Schedule
Why Near-Critical Paths Matter in Construction Project Scheduling
How to Build a Resource-Loaded Construction Schedule: Complete Guide
De-Risk the Supply Chain, Keep Procurement on the Critical Path
Protecting the Pro Forma: Why Owners Need Direct Eyes on the Capital Improvement Schedule
The Complete Guide to Data Center Construction From Planning to Turnover
How Long Does Data Center Construction Take? Timeline, Phases, and Challenges
AI Agents for Construction: Use Cases, Benefits and Examples
AI Construction Scheduling Tools in 2026: Types, Features and How to Choose
Legacy Tools
Weren’t Built
for Data Center Construction
Planera Names Stephen Archibald Chief Financial Officer
Planera Brings One-Click Schedule Sync to Autodesk Forma
How to Use AI in Construction: Practical Use Cases for Construction Teams
What's New in September
Five Takeaways from the Built for the AI Boom: Data Center Webinar
How to Conduct Delay Analysis for Construction Projects: Methods, Claims and Best Practices
De-Risking the Supply Chain: How Visual Sequencing Keeps Long-Lead Procurement on the Critical Path
What's New in Planera: July 2026
How to Develop a Commercial Construction Project Schedule
What's new in Planera: August 2026
How Construction Schedule of Values Helps Manage Project Costs and Payments
Construction Firms Face Autumn Microsoft Project Retirement Deadline
The Scheduler's Playbook
The Blueprint for Project Success: Why Collaborative Planning and AI are Redefining Construction Scheduling
How Construction Schedule Levels Improve Project Planning and Execution
Moving Beyond the Gantt Chart
Flipping the Construction Profit Equation
Making Schedules Accessible
How to Create a Construction Master Schedule and Manage a Project Timeline Successfully
Every Project You've Ever Seen Run Late Was Scheduled on Software from 2007
Construction Milestone Schedule: How to Plan Key Project Dates and Keep Projects on Track
The High Cost of Inaction: Why Sticking with Legacy Scheduling is Eroding Contractor Margins
What's new in Planera (June 2026): schedule changes with Manny, searchable notes, and more
Construction Fast Tracking: What It Is, When to Use It, and What Can Go Wrong
Lean Construction Scheduling: Principles, Techniques, and Benefits
Pull Planning in Construction: Process, Benefits, and Examples
Construction Sequence Plan: How to Sequence Work for Better Project Flow
Critical Path Method (CPM) in Construction: A Full Guide
What's New in Planera: May 2026
Moving From
Legacy Tools to Modern CPM, the Complete Guide for Modern Construction Teams
Elevating Construction Success: The Planera Support Advantage
The Shift from Oracle P6 to Planera: Why Leading Contractors are Choosing Collaborative Scheduling
Lookahead Scheduling in Construction: How to Plan Without Slowing the Job Down
New AI Agent Changes Construction Scheduling..Are Schedulers Now Redundant?
Construction Scheduling 101: Complete How-to Guide for Project Managers [2026]
What's New in Planera: April 2026
Planera Releases AI Schedule Assistant; DPR Rolls Out ConstructivIQ on 120+ Projects
Planera Launches Manny, Turning Construction Schedules Into Live Decision Engines
Scheduling Without a Data Date Is Not Just Bad Practice, It's a Liability
Microsoft Project Alternatives for Construction: What to Use After Project Online
July Product Updates: Better bulk actions, Hide collaborator cursors & more
August Product Updates: Four new features + a speed boost you’ll love
September Product Updates: Smarter Permissions, Sharper Insights, Richer Context
October Product Updates: New sorting for P6 imports, flexible IMS, edit-in-Gantt, and more
November Product Updates: Clearer navigation, smarter safeguards, and smoother interactions
December Product Updates: update schedules with confidence, investigate issues faster, and avoid cleanup work
Primavera P6 Alternatives for Construction: A 2026 Buyer's Guide
The MS Project Retirement: Why Construction Leaders are Securing Their Future with Planera
February 2026 Product Marketing Update
How to Read and Use a Gantt Chart for Construction Scheduling
Best CPM Software for Construction in 2026: Types and How to Choose
Building Data Centers Faster and Smarter: Visual, Collaborative Scheduling Isn’t Just an Option—It’s a Business Mandate.
How Big-D Construction uses Planera to avoid ‘death by 1,000 paper cuts’
The Future of Construction Scheduling for GCs to Improve with AI using Planera
Construction Management Software in 2026: Types, Features and How to Choose
From Trailer to Tablet: Making Schedules Work Where the Work Happens
12 Digital Construction Tools Every Contractor Needs in 2026
Construction Scheduling Software in 2026: How to Compare Your Options
Change Leader: Why Infrastructure Projects Lose Margin Before They Break Ground
Planera Adds Industry Leaders Matt Burness and Mark Baracani to Strengthen Product and Construction Expertise
Planera Expands Data Centre Presence with New Funding
‍Planera Accelerates Data Center Expansion, Raises $8M in New Funding
Miles-McClellan Expands Scheduling with Planera for iPad
Planera September Update: Smarter Permissions, Sharper Insights, Richer Context
AMLI Residential Selects Planera to Transform Project Scheduling and Field Collaboration
The Future is Hybrid: Why Modern Construction Demands both CPM and Lean
The Evolution of Construction Scheduling in the Design-Build Era
Planera Featured on the Art of Construction Podcast
Report: Legacy Tools & Hiring Top Concerns Amid Construction Boom
Sticky Notes Don’t Scale: 5 Reasons to Choose Logic-Driven Scheduling
Drill Tech Selects Planera for Schedule-Critical Tunnel Projects
Scheduling That Keeps Up with Data Center Demands
Bridging the Skills Gap: PlaneraEDU Prepares Digital Jobsite Pros
Watch the Webinar! Planera Field Schedules Linked to Master Plan
Planera Wins 2025 Gold Globee® Award for Disruptors
Planera Launches Collaborative Field Scheduling for Teams
Planera CEO Nitin Bandhari Featured on ENR's Critical Path Podcast
Nitin Bhandari Wins Best Innovative Entrepreneur Award
Not a ‘Shiny Toy’: Contractor Overhauls Scheduling Without Hype
